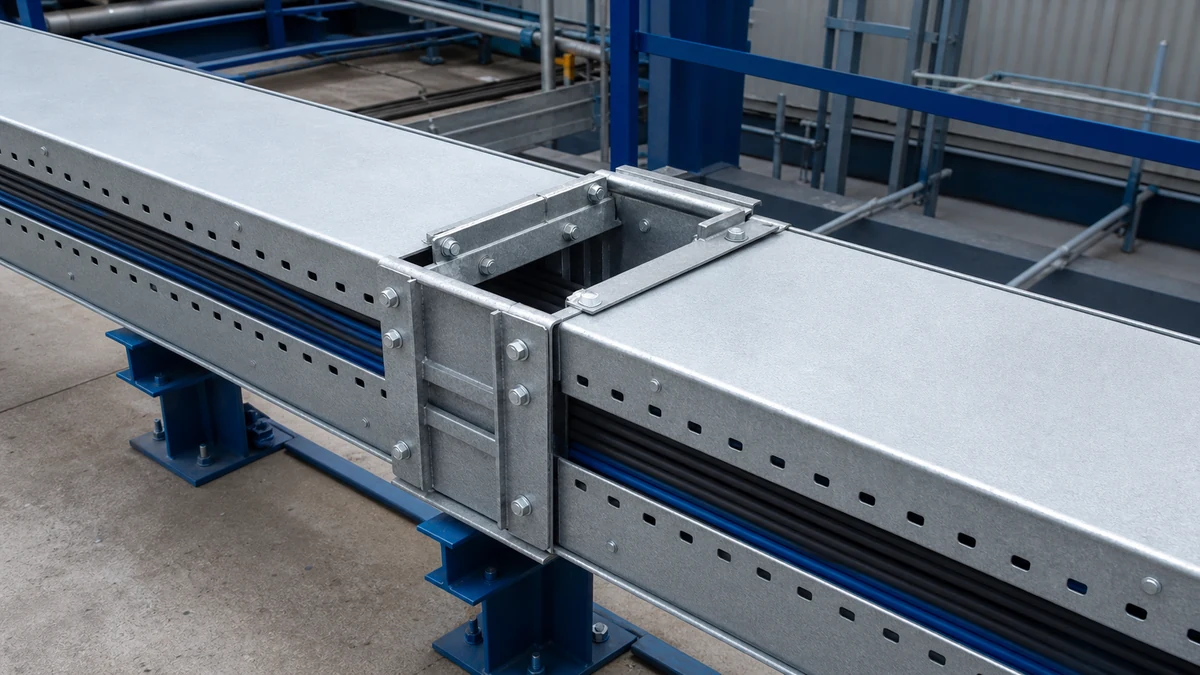

Cable tray expansion joints allow a tray assembly to accommodate movement that may arise from temperature change, long continuous runs, building movement, or a structural expansion location. They are not a generic accessory to be added at a fixed interval or calculated from a universal formula. The selected component, joint gap, bonding detail, support arrangement, cable allowance, and installation setting must each match the system drawing and the project’s movement assessment before work begins.
The sections below provide a structured approach to coordinating an expansion joint across the full life of a cable tray system route, from initial movement-condition assessment through close-out inspection.

The first task is to characterise what the tray must accommodate. Work from the route drawing and confirm the following inputs with the project’s structural and electrical teams before specifying any component.
Movement-Condition Decision Table
| Condition to evaluate | Governing input | Action required |
|---|---|---|
| Tray material and finish | Specification and procurement schedule | Confirm expansion-joint family matches exactly |
| Longest continuous tray section | Route drawing with dimensions | Identify locations where movement must be managed |
| Anticipated temperature range | Site climate data and operating environment | Feed into designer’s movement assessment |
| Indoor or outdoor exposure | Route classification | Confirm finish, sealing, and cover requirements |

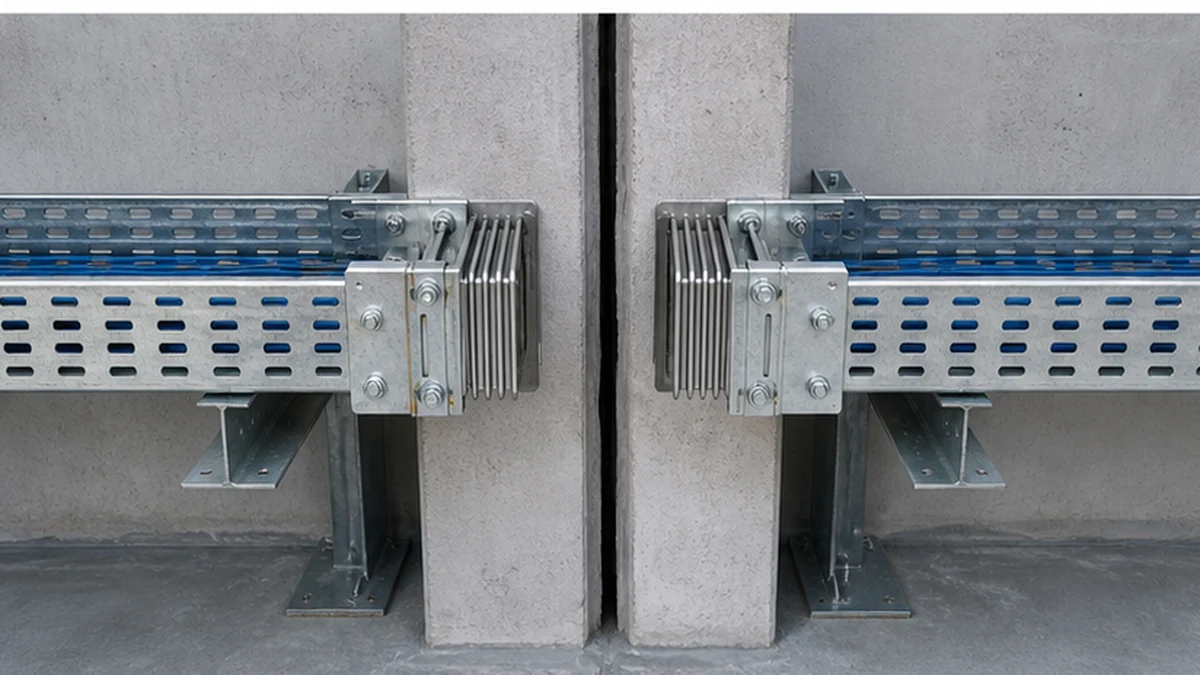

| Structural building expansion joint | Structural drawings | Align tray joint location with structural joint |
| Transition between buildings or zones | Architectural and structural drawings | Confirm sleeve, fire-stopping, and access coordination |
| Passage through wall or into equipment | Penetration and equipment drawings | Confirm clearance, cover, and restraint detail |
Do not translate a general thermal-expansion formula into a release-for-construction detail without verifying the selected tray system against this table. Each row represents a condition that may govern the joint location, setting, or hardware selection independently. IEC 61537 is relevant to the tray system as a product standard; use it alongside the project design documents rather than as a substitute for the movement assessment.

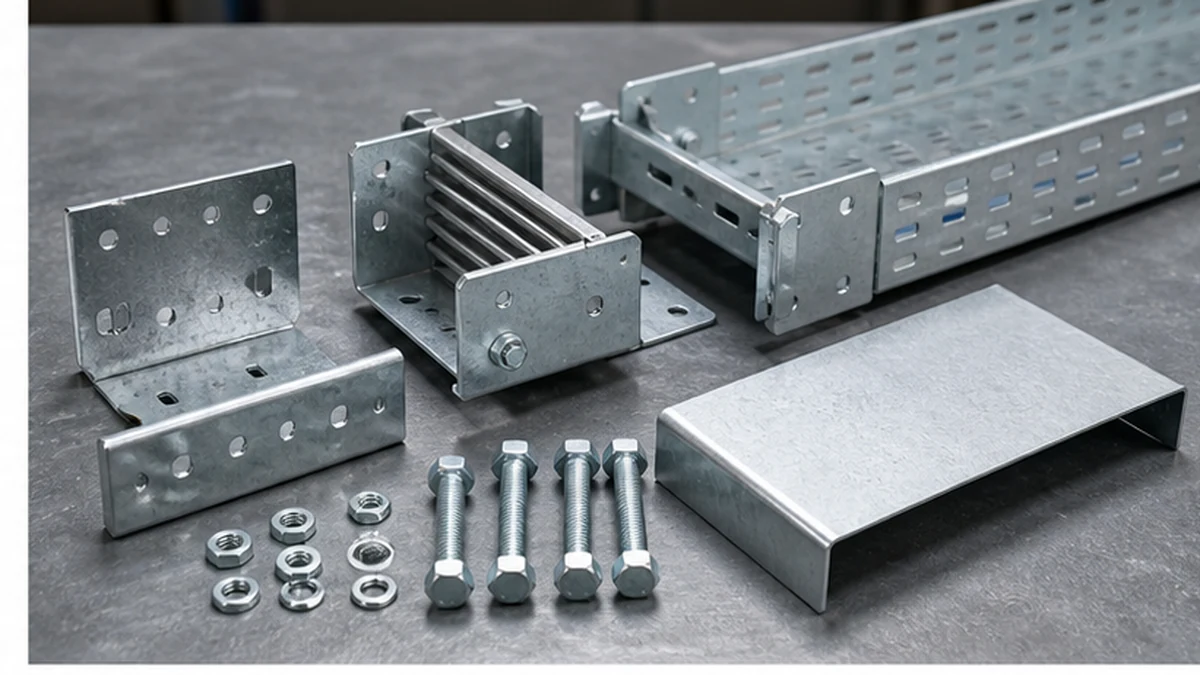

An expansion joint is typically more than a sliding mechanical connection. It may require matching side plates, splice hardware, fasteners, cover transition pieces, divider extensions, and bonding jumpers. Ordering parts from unrelated tray families introduces dimensional and finish mismatches that are difficult to correct after installation.
Use the checklist below before releasing a material order.
Component and Cover or Divider Compatibility Checklist
Cross-check required clips, cover pieces, and hardware against the cable tray accessories range for the specific tray family. Then obtain the approved component detail by reviewing the cable tray fittings range to confirm that the selected fitting matches the actual profile and finish. A joint that appears mechanically similar to an alternative may carry a different permitted movement range and should not be treated as interchangeable.

Cable behaviour across a movement location requires deliberate design. The cable path must accommodate the intended joint action without being blocked by over-restraint and without creating unsupported loops or obstruction to access. The following items should be confirmed before cables are laid in and covers are fitted.
Cable Allowance and Bonding Coordination — Items to Confirm
| Item | Design responsibility | Installer check |
|---|---|---|
| Cable slack across the joint | Electrical designer | Verify loop length matches approved detail |
| Minimum bend radius at allowance loop | Cable supplier data and electrical designer | Confirm no tight bend at restraint clamps |
| Restraint clamp positions on each side of joint | Electrical designer | Do not clamp within the movement zone unless detailed |
| Divider continuity across joint | Electrical designer | Confirm divider transition piece is fitted |
| Cover clearance over cable allowance loop | Electrical designer | Check clearance with cover in place |
| Cable separation maintained through joint | Route drawing | Confirm separation is not lost at the transition |
| Bonding jumper type and routing | Electrical designer | Install per approved detail, not assumed from mechanical contact |
| Bonding method recorded for inspector | Electrical designer | Visible notation on as-built drawing or inspection sheet |
Do not clamp a cable so tightly on both sides of a movement location that the intended joint action is blocked. Equally, do not leave unmanaged cable loops that obstruct access or create an unsupported condition. Treat the bonding detail as a design item. The sliding mechanical connection should not be assumed to provide the required electrical continuity path unless the approved project detail explicitly states that it does. Record the approved bonding method and make it accessible to both the installer and the close-out inspector.

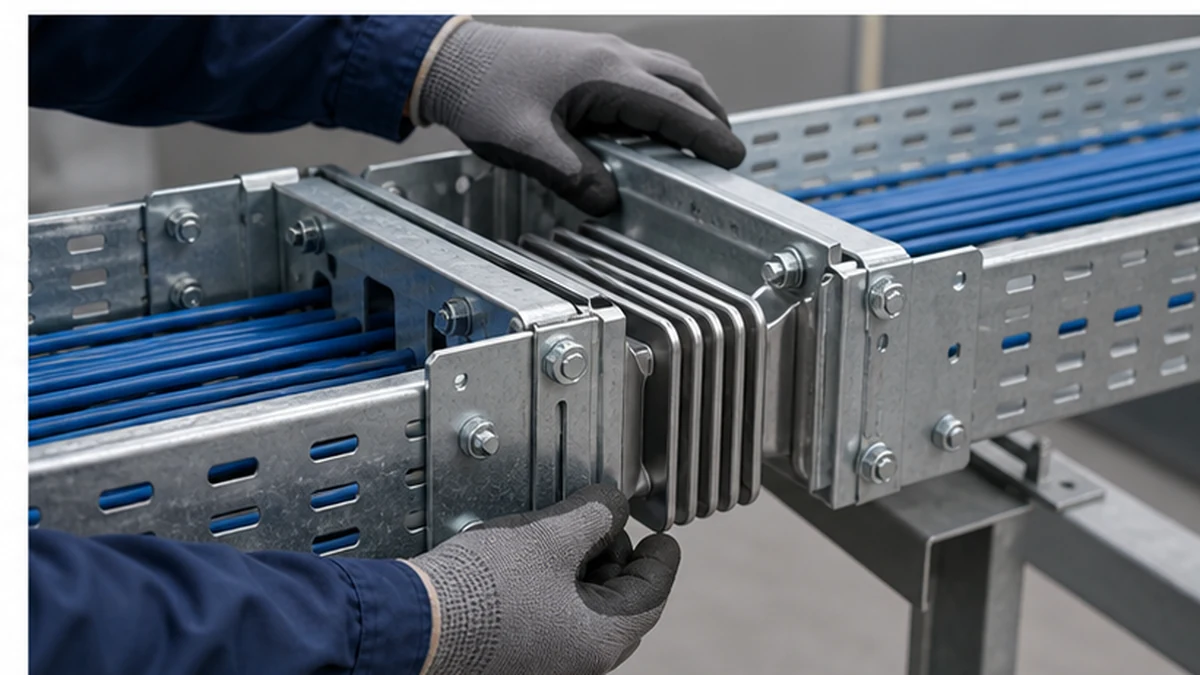

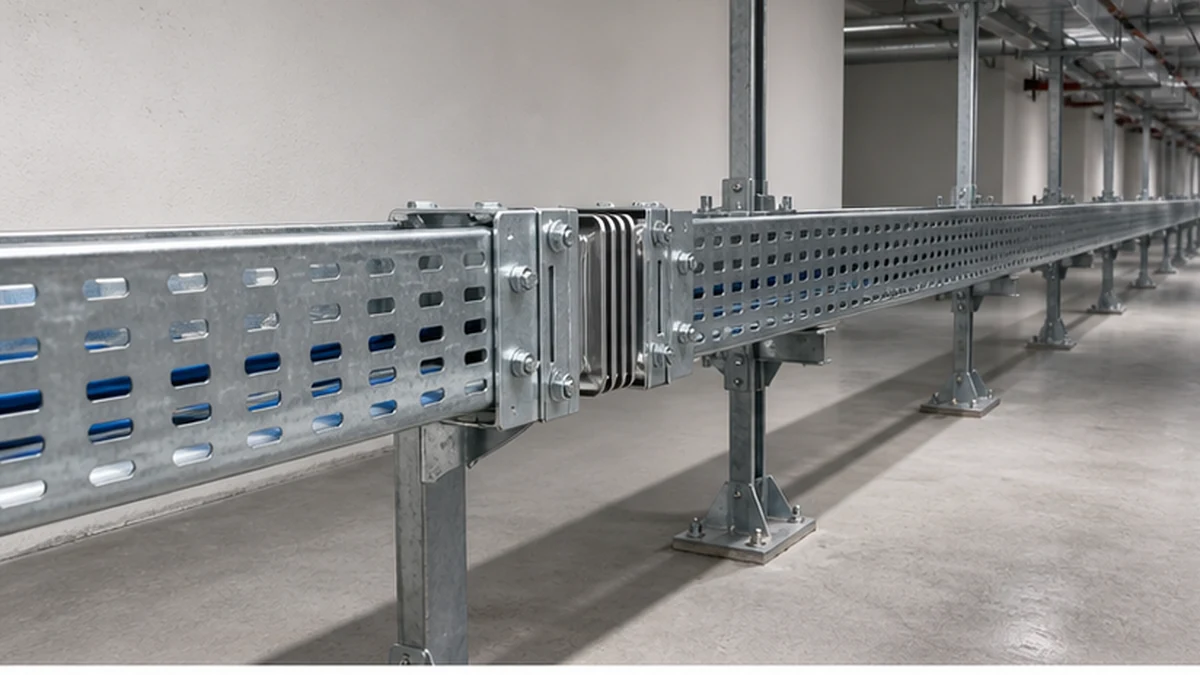

Support placement determines how an expansion joint functions. The joint detail should identify which tray sections are restrained and which are permitted to move, and that information must reach the crew installing the supports before any brackets are fixed.
Support and Restraint Workflow
A support placed across the wrong part of a joint can defeat the design even when the correct component was purchased and installed. This step should be treated as a site-hold point, not a routine check.

Before fitting any component, compare the delivered joint against the approved model code, material, finish, tray profile, and detail revision. A mismatch at this stage is easier to resolve than after cables are in place.
Pre-Installation Verification Checks
Add a dedicated inspection hold point before cables and covers conceal the connection. The cable tray installation guide provides broader sequencing context for tray routes; expansion joints require this additional verification step because errors are difficult to detect once the run is loaded and covered.
A structured close-out record makes the installation verifiable and supports future maintenance or modification decisions. The table below identifies the items that should be confirmed before the route is handed over.
Close-Out Inspection Record — Expansion Joint Location
| Inspection item | Confirmed | Notes |
|---|---|---|
| Component model code and revision match approved drawing | ||
| Installation gap setting recorded | ||
| Support positions match restrained or free designation | ||
| Cable allowance loop fitted and clear of obstruction | ||
| Bend radius at loop acceptable | ||
| Cable restraint clamps positioned outside movement zone | ||
| Divider transition fitted where required | ||
| Cover transition fitted and clear of cable loop | ||
| Bonding jumper fitted per approved detail | ||
| Bonding method recorded on as-built drawing | ||
| Fire-stopping or sleeve confirmed at wall penetration | ||
| Inspector signature and date |
Retain a completed copy for the project record. Where multiple expansion joints are installed on a long run, complete a separate row set or record sheet for each location rather than using a single sign-off for the entire route.

For expansion-joint locations specifically, Xinma’s manufacturing range includes the tray sections, compatible fittings, cover and divider transitions, joint hardware, seismic-bracing components, and busway interfaces that may appear on the same route. The value of working within one product ecosystem at a movement location is that tray profile dimensions, coating class, hole patterns, and cover interfaces share a common approved drawing set. This makes delivery verification more straightforward and reduces the risk of a cover or divider transition arriving on site without a matching tray sidewall geometry. Site-inspection checks become more consistent when the BOM draws from a single family: the inspector can cross-reference model codes against one approved detail rather than reconciling parts from separate systems. Where seismic-bracing requirements apply to the same route, confirm that the bracing hardware is coordinated with the expansion-joint restrained-support positions so that the two systems do not work against each other.
No. Joint locations and settings must follow the selected system detail and the project’s movement, material, temperature, and structural conditions. There is no universal spacing figure that applies across different tray materials, finishes, building types, or route configurations.
Only if the manufacturer’s approved project detail explicitly identifies that splice plate for the movement condition in question. A fixed splice plate and a designed movement component serve different structural purposes and should not be substituted for each other without an approved change from the designer.
Do not assume so. The sliding mechanical connection may not provide a reliable or code-compliant bonding path. Follow the project’s defined bonding and continuity method for the selected system and record the approved method so that installers and inspectors can verify it.
Use the approved route detail for cable slack allowance, restraint clamp positions, minimum bend radius, cable separation maintenance, and inspection-access requirements. The allowance must accommodate the intended joint movement without blocking it and without creating unsupported or obstructed cable conditions.
Supports determine which tray section is restrained and which is free to move. A support placed incorrectly can prevent the joint from functioning as designed, even when the correct component has been purchased and installed. Confirm restrained and free-slide positions against the manufacturer’s approved drawing before fixing any bracket.
